Gantt Chart in plotly

A Gantt chart is a popular way of representing a project schedule. It is a type of bar chart that illustrates a project timeline, including the start and end dates of tasks and their dependencies. Gantt charts are widely used in project management to visually represent project plans and track progress. In this article, we'll explore how to create Gantt charts in Python using the Plotly library.

Installation

First, install the Plotly library using pip ?

pip install plotly

Syntax

The basic syntax for creating a Gantt chart in Plotly uses the px.timeline() function ?

import plotly.express as px

fig = px.timeline(df, x_start="Start_Date", x_end="End_Date", y="Task_Name")
fig.show()

Basic Gantt Chart Example

Let's create a simple Gantt chart with three tasks ?

import plotly.express as px
import pandas as pd

# Create sample data
df = pd.DataFrame({
   "Task_Name": ["Task 1", "Task 2", "Task 3"],
   "Start_Date": ["2022-01-01", "2022-01-03", "2022-01-06"],
   "End_Date": ["2022-01-02", "2022-01-05", "2022-01-09"]
})

# Create the Gantt chart
fig = px.timeline(df, x_start="Start_Date", x_end="End_Date", y="Task_Name")
fig.update_yaxes(categoryorder="total ascending")
fig.show()

print(df)
  Task_Name Start_Date    End_Date
0    Task 1 2022-01-01  2022-01-02
1    Task 2 2022-01-03  2022-01-05
2    Task 3 2022-01-06  2022-01-09

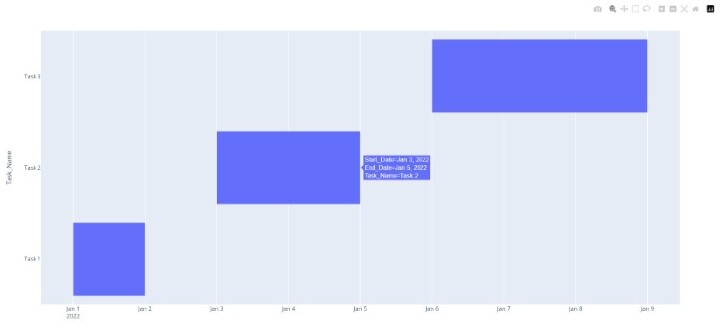

Basic Gantt Chart

Adding Custom Colors

You can customize the appearance by adding colors to different tasks ?

import plotly.express as px
import pandas as pd

# Create data with color column
df = pd.DataFrame({
   "Task_Name": ["Task 1", "Task 2", "Task 3"],
   "Start_Date": ["2022-01-01", "2022-01-03", "2022-01-06"],
   "End_Date": ["2022-01-02", "2022-01-05", "2022-01-09"],
   "Resource": ["Team A", "Team B", "Team A"]
})

# Create colored Gantt chart
fig = px.timeline(df, x_start="Start_Date", x_end="End_Date", y="Task_Name", color="Resource")
fig.update_yaxes(categoryorder="total ascending")
fig.show()

print(df)
  Task_Name Start_Date    End_Date Resource
0    Task 1 2022-01-01  2022-01-02   Team A
1    Task 2 2022-01-03  2022-01-05   Team B
2    Task 3 2022-01-06  2022-01-09   Team A

Colored Gantt Chart

Key Parameters

Parameter Description Example
x_start Column name for start dates "Start_Date"
x_end Column name for end dates "End_Date"
y Column name for task names "Task_Name"
color Column for color grouping "Resource"

Real-World Project Example

Here's a more realistic project management example ?

import plotly.express as px
import pandas as pd

# Create realistic project data
project_data = pd.DataFrame({
   "Task": ["Planning", "Design", "Development", "Testing", "Deployment"],
   "Start": ["2024-01-01", "2024-01-15", "2024-02-01", "2024-03-15", "2024-04-01"],
   "Finish": ["2024-01-14", "2024-01-31", "2024-03-14", "2024-03-31", "2024-04-07"],
   "Team": ["Management", "Design", "Development", "QA", "DevOps"]
})

# Create professional Gantt chart
fig = px.timeline(project_data, x_start="Start", x_end="Finish", y="Task", color="Team")
fig.update_layout(title="Software Development Project Timeline")
fig.update_yaxes(categoryorder="array", categoryarray=project_data["Task"][::-1])
fig.show()

print("Project Timeline:")
print(project_data)
Project Timeline:
        Task       Start      Finish        Team
0    Planning  2024-01-01  2024-01-14  Management
1      Design  2024-01-15  2024-01-31      Design
2 Development  2024-02-01  2024-03-14 Development
3     Testing  2024-03-15  2024-03-31          QA
4  Deployment  2024-04-01  2024-04-07      DevOps

Applications

Gantt charts are versatile tools used in various scenarios ?

  • Project Management Track project phases and milestones

  • Resource Planning Visualize team workload and allocation

  • Event Planning Coordinate activities and deadlines

  • Software Development Manage sprints and releases

Conclusion

Plotly's Gantt charts provide an effective way to visualize project timelines in Python. Use px.timeline() with start/end dates and task names to create interactive charts. The color parameter helps group tasks by teams or categories for better project management insights.
